← Back to blog

Electrical quoting guide: pricing jobs for profit

August 23, 2026
Electrical quoting guide: pricing jobs for profit

Every electrical quote comes down to one formula: materials + labour + overhead + profit = price. Get those four numbers right and you have a defensible quote. Get any one wrong and you're either losing money on the job or losing the job to a cheaper bid.

The standard approach recommended by leading estimating guides is a hybrid pricing model: flat-rate pricing for repeatable, well-understood tasks (socket installs, light fittings, consumer unit swaps) and hourly or time-and-materials pricing for anything with genuine unknowns, like fault-finding in an old rewire or opening up a wall to find out what's actually behind it.

Before you leave site, do this one thing: run a short survey checklist and write a not-to-exceed clause into any time-and-materials work.

  • Confirm supply type, earthing arrangement, and consumer unit condition
  • Photograph the fuse board, cable routes, and any visible damage
  • Note access constraints (loft, floor voids, finished walls)
  • Ask the client directly about scope changes they might already be planning
  • Cap open-ended T&M work with a stated ceiling before extra costs kick in

That last point protects you from the single biggest cause of quoting regret: agreeing to "sort it out" without a number attached.

Key Takeaways

Profitable electrical quoting comes down to pricing every job on true cost (materials, true billable labour, allocated overhead) plus a deliberate margin, never on gut feel.

PointDetails
Use the core formulaPrice every job as materials plus labour plus overhead plus profit, never as a rough guess.
Match the pricing model to the jobUse flat-rate for repeatable tasks and time-and-materials with a cap for genuine unknowns.
Know your true hourly rateCalculate overhead per billable hour, not total hours, so non-billable time doesn't erode margin.
Separate provisional from fixed quotesLabel unverified scope clearly so unexpected findings don't become disputes.
Use TradeWise for field quotingSync material prices and quote from site using TradeWise's estimate template to cut errors and speed up acceptance.

Table of Contents

Step-by-step electrical quoting guide: from survey to final price

A reliable estimate isn't guesswork dressed up in a spreadsheet. It's a repeatable sequence, and the electricians who quote profitably tend to run the same five steps every time, in the same order.

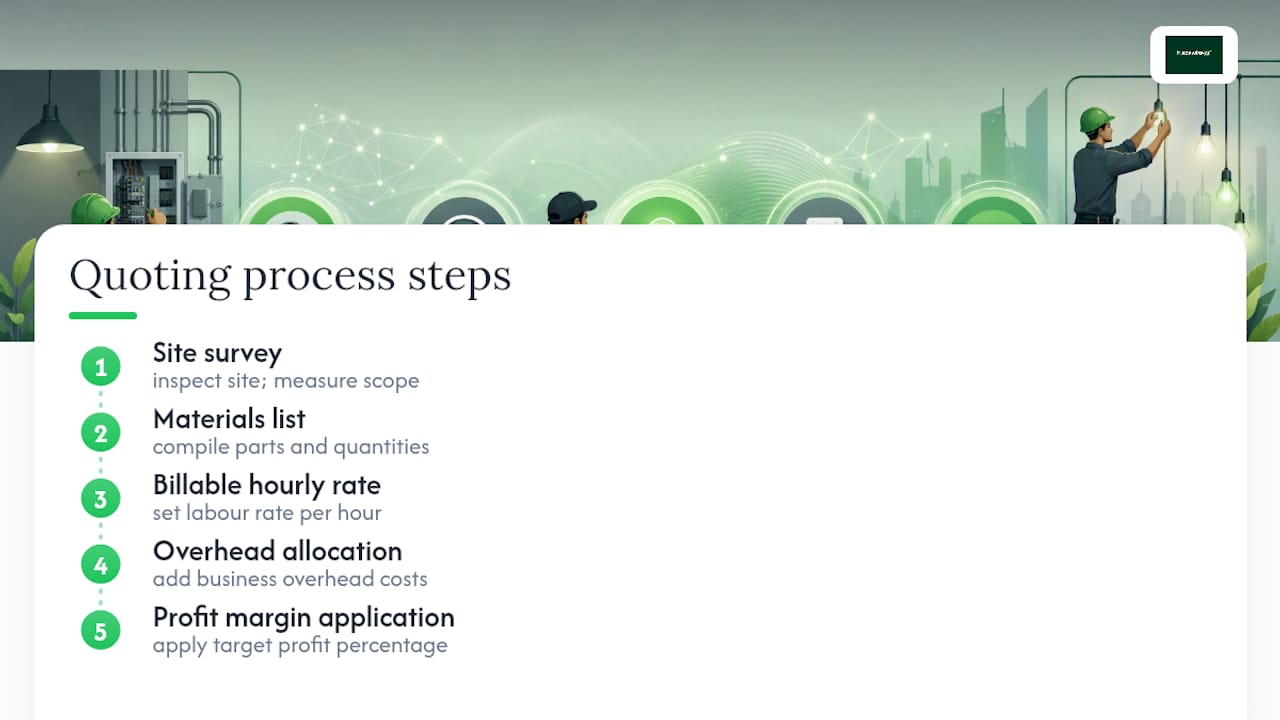

Step-by-step electrical quoting workflow diagram

1. Run the site survey properly

Walk the job before you price it, always. A five-minute walk-round catches the things that turn a profitable job into a loss-maker: an inaccessible loft hatch, a consumer unit that needs relocating, cabling routed somewhere nobody mentioned on the phone.

Write an assessment summary on the spot: what you saw, what you measured, and what you're assuming (because every quote rests on assumptions, and the ones you don't write down are the ones that bite you later). Photograph everything, including things that seem irrelevant. A photo of the meter cupboard from six weeks ago has settled more disputes than any verbal recollection ever has.

2. Build the materials list properly

Do a proper quantity takeoff, not a rough guess based on similar jobs. Count sockets, metres of cable, back boxes, glands, consumer unit ways, RCBOs, everything. Price each line against current supplier costs rather than what you paid six months ago; copper and cable prices move, and a stale price list is a quiet way to erode your margin.

Electrician hands counting electrical components

Apply a materials markup on top of trade cost, typically somewhere in the 15 to 25 percent range depending on your supplier relationships and how much handling and delivery risk you're absorbing. Some electricians skip this because it feels like "profiteering" on top of labour margin. It isn't. You're the one who ordered it, stored it, and stands behind it if it's faulty.

3. Work out your true billable hourly rate

This is where most new contractors underprice themselves without realising it. Your day rate isn't your hourly wage divided across eight hours; it has to cover the hours you don't bill for.

Add up your annual overhead (van, insurance, tools, training, admin time, quoting time, marketing) and divide it across your realistic billable hours, not your total working hours. If you work 46 weeks a year at eight hours a day but only bill for six of those hours (the rest goes on driving, quoting, paperwork and material runs), your true billable-hour cost is meaningfully higher than a simple wage-divided-by-hours calculation suggests.

Pro Tip: Track your actual billable hours for one full month using a time log. Most electricians find they're only billing 60 to 70 percent of their working day, which means their real hourly cost is a third higher than they assumed.

4. Allocate overhead per billable hour

Once you know your realistic billable hours per year, divide your total annual overhead by that number. That gives you an overhead cost per hour, which gets added on top of your bare labour rate before you even think about profit.

A worked example: £18,000 in annual overhead divided by 1,100 realistic billable hours gives roughly £16.36 per hour in overhead alone. Add that to your wage-equivalent labour rate, and you've got your true cost-per-hour before profit is even applied.

5. Apply your profit margin and sanity-check the number

Estimating tools built for tradespeople typically recommend a gross margin target in the 25 to 40 percent range on installation work, with the lower end for straightforward, low-risk jobs and the higher end reserved for complex or high-liability work like consumer unit upgrades and EV charger installs.

Sanity-check every quote against two numbers before you send it: your minimum acceptable margin (the floor below which the job isn't worth doing) and your target margin (what a well-run version of this job should return). If a quote only clears your floor, ask yourself why. Usually it's because the labour estimate was optimistic, not because the client got a good deal.

Choosing between hourly, flat-rate and hybrid pricing

The pricing model you choose matters almost as much as the number itself, because the wrong model on the wrong job is how good electricians end up working for free on the hours nobody accounted for.

Hourly or time-and-materials pricing is the right call when the scope is genuinely unknown: fault diagnosis, intermittent faults, rewiring an older property where you can't see behind every wall until you open it up. Charge for your time and materials as you go, but always cap it with a not-to-exceed figure so the client isn't blindsided by the final invoice.

Flat-rate pricing works for anything repeatable and well-defined: a consumer unit swap, an EV charger install, adding a double socket. You've done the job forty times, so you already know roughly how long it takes and what it needs. Flat-rate pricing built from per-task benchmarks also makes your quotes faster to produce, which matters when you're competing against three other electricians for the same job.

A few practical rules worth adopting:

  • Structure a three-tier offer (basic, standard, premium) on bigger jobs; research on electrical bidding shows most clients choose the middle tier, which quietly lifts your average job value without you having to push anyone toward it.
  • Set a call-out multiplier for emergency and after-hours work, typically double the standard rate or more, and state it upfront rather than surprising the client on the invoice.
  • Never quote flat-rate on anything where you can't see the full scope. If you can't confirm it, price it as T&M with a ceiling.
  • Review your tier pricing every six months against material cost changes; a basic tier priced last year is often quietly loss-making today.

Rate benchmarks and typical job price ranges

Standard electrician hourly rates in the UK typically centre around £40 per hour for daytime, non-emergency work, with call-out and emergency rates commonly running £80 to £100 per hour depending on region and time of day. Those figures sit alongside broader UK rate surveys from platforms like MyBuilder, which show similar bands once you account for regional variation, with London and the South East typically sitting above the national average.

Typical UK rate bands: Standard hourly work around £40/hour. Emergency call-outs commonly £80 to £100/hour. These are national benchmarks, not fixed prices, so adjust for your region, overhead, and specialism.

Common job price ranges give you a sanity-check against your own quote before it goes out:

Job typeTypical price range
Single socket or switch installLow, priced per unit
Light fitting replacement or additionLow to moderate
Consumer unit replacementModerate, higher with additional circuits
EV charger installationModerate, varies with cable run length
Whole-house rewireHigh, priced per circuit or per room

Treat these as a starting point rather than gospel. Access difficulty changes everything: a socket install in an open stud wall takes fifteen minutes; the same socket in a finished, plastered wall with hidden cable runs can take an hour and needs making good afterwards, which is a separate cost most new quotes forget to itemise.

Working in occupied, finished spaces (a family's lounge rather than a bare shell) also justifies a premium. You're working around furniture, protecting flooring, and often working slower and more carefully than you would on a first-fix job. Permit-related costs, where Building Regulations notification or Part P certification applies, should be itemised separately rather than buried in the labour line, because clients query hidden costs far more than they query clearly labelled ones.

For internal consistency, price per circuit or per device rather than per job whenever you can. It flags scope drift early: if a "simple rewire" is suddenly costing you 40 percent more per circuit than your last three jobs, something in the estimate was wrong before you even started.

Writing a quote clients accept without haggling

A written quote either builds trust or invites negotiation, and the difference usually comes down to how much detail you include, not how low the price is.

Every quote should carry: an assessment summary describing what you found on site, a detailed scope of work broken into stages, and an itemised pricing breakdown showing materials, labour, and permit or certification fees separately rather than one lump figure. Clients trust itemised quotes more, because a lump sum invites the question "what am I actually paying for?"

  • State your deposit requirement and payment schedule clearly (deposit, interim, on completion)
  • Note warranty terms and what they cover, in plain language
  • Include a change-order clause: any scope change gets priced and agreed before work continues
  • Set a not-to-exceed cap on any T&M elements, so unknowns can't run wild
  • Deliver the quote as a signed PDF and keep it in a searchable job file

Using consistent template clauses across every quote, rather than writing terms from scratch each time, is one of the simplest ways to cut disputes. Our guide to common construction quoting errors covers the specific wording mistakes that tend to cause the most arguments after the job's already started.

How TradeWise supports this quoting workflow in the field

A quoting method only works if you can actually run it on site, on your phone, between jobs, not back at a desk that evening.

TradeWise's free contractor estimate form template gives you a ready-made structure for the survey-to-quote-to-invoice flow described above, so you're not rebuilding the same document from scratch on every job.

  • Synced material pricing means your quotes reflect current supplier costs, not last month's guess
  • Mobile quoting lets you send a professional, itemised quote from site, before the client's excitement cools off
  • Field-first quoting materially cuts time-to-acceptance and quoting errors compared with quotes built later at a desk
  • Digital job files keep photos, quotes, and signed acceptances together for every job

Handling contingencies and unexpected costs in quotes

Every experienced electrician has opened a wall and found something the client never mentioned: outdated cabling that doesn't meet current standards, asbestos in an older property, or a supply that turns out to be undersized for the load. Contingency planning is what stops these discoveries from becoming arguments.

Build a contingency line into quotes for jobs with any hidden-scope risk, typically a percentage of the total (many contractors use somewhere between 10 and 15 percent as a working figure, though this should reflect your own risk assessment rather than a fixed rule). State it openly on the quote as a contingency allowance rather than folding it invisibly into your labour rate, because a client who sees "contingency: possible additional cost if X is found" is far less likely to dispute it later than one who's blindsided by a change order.

Electrician opening wall for wiring inspection

For genuinely unpredictable jobs, price the known scope as flat-rate and the unknown elements as time-and-materials with a stated cap. That way the client gets certainty where certainty is possible, and transparency where it isn't. Document every contingency trigger clearly: what specifically would cause the extra cost, and roughly what that cost would be, so there's no ambiguity when (not if) it happens.

Electrical work in the UK sits under BS 7671 (the IET Wiring Regulations) and, where relevant, Part P of the Building Regulations for notifiable work in England and Wales. Your quote should reflect awareness of both, even if the detailed compliance work happens after acceptance.

If a job requires Building Regulations notification, either through a competent person scheme or local authority building control, state that on the quote and clarify who's responsible for the certification cost. This is a detail that gets forgotten constantly, and forgetting it is how contractors end up absorbing a certification fee they never priced in.

Quotes should also reflect your scope of competence. If a job needs sign-off from a scheme you're not registered under, or crosses into work you'd need to subcontract (three-phase supply work, for instance), say so upfront rather than quoting the full job and scrambling later. Clients respect honesty about scope far more than they respect a contractor who quietly farms out work they weren't qualified for in the first place.

Differentiating between provisional and fixed quotes

A fixed quote is a firm price for defined, fully-scoped work. A provisional quote (sometimes called an estimate) is your best professional judgement on a job where full scope isn't yet known, and the two should never be presented to a client as interchangeable.

Label each document clearly. If you're not confident you've seen everything (a loft you couldn't access, wiring you couldn't trace, a fuse board you suspect is undersized but haven't confirmed), issue a provisional figure and say so explicitly: "This is a provisional estimate. The fixed price will be confirmed once [specific unknown] is verified." That single sentence does more to prevent disputes than almost anything else in this guide.

Fixed quotes carry more commercial weight because they're binding once accepted, so reserve them for jobs where your site survey genuinely covered everything relevant. Rushing a fixed price on an under-surveyed job is one of the most common ways contractors end up eating costs they never agreed to.

Incorporating warranties and guarantees in the quote

State your warranty terms on every quote, not just for larger jobs. A one-year workmanship guarantee on a socket install and a five-year guarantee on a consumer unit replacement are both reasonable, but the client needs to see the distinction written down rather than assuming everything carries the same cover.

Separate workmanship warranties (your labour and installation quality) from manufacturer warranties on the equipment itself (a consumer unit or EV charger typically carries its own manufacturer guarantee, independent of your work). Conflating the two is a common source of disputes when a component fails and the client assumes you're liable for a manufacturing fault.

Be specific about what voids the warranty. If subsequent work by another contractor invalidates your guarantee, say so on the quote itself. Clients who understand the boundaries of a warranty upfront are far less likely to push back on it later, and a clearly stated warranty is also a genuine competitive advantage against a cheaper quote that's silent on the subject.

Best practices for updating and revising quotes

Quotes go stale. Material prices move, site conditions change, and a quote sitting unanswered for six weeks is a different proposition to the same quote on day one. Put an expiry date on every quote, typically 30 days, so you're never bound to a price that no longer reflects your actual costs.

When a client wants to revise scope after acceptance, issue a formal change order rather than a verbal adjustment. State the change, the price impact, and get sign-off before continuing, even if it feels awkward to pause mid-job for paperwork. That pause is what protects the margin you originally calculated.

If you discover something during the work that wasn't visible during the survey, stop and requote the affected element rather than absorbing it silently. Contractors who eat unexpected costs to avoid an awkward conversation are training their clients to expect it every time, on every future job.

Communication strategies for negotiating and clarifying quotes with clients

Most quote negotiations aren't really about price. They're about clients not understanding what they're paying for, so the first negotiation tactic is simply better explanation, not a lower number.

Walk through the itemised breakdown verbally before you leave site, not just on paper. Explain why the consumer unit costs what it costs, why the labour hours are what they are, and what happens if something unexpected turns up. Clients who understand the reasoning behind a number are dramatically less likely to challenge it than clients who just see a total.

When a client does push back on price, resist the urge to simply discount. Instead, offer to adjust scope: a lower-tier consumer unit, a phased approach, fewer sockets in the first phase. This protects your margin while still giving the client a way to say yes. If a client asks you to match a competitor's lower quote, ask what's included in that quote before responding; often it's missing certification, warranty, or a contingency allowance that yours includes, and that's a stronger response than simply cutting your price to match.

Why field-ready quoting beats theoretical pricing models

Most quoting advice treats pricing as a spreadsheet exercise, done at a desk, after the job's been surveyed. That's backwards for most working electricians. The quote that wins the job is the one sent within hours of the site visit, while the client's still enthusiastic and before three other contractors have had time to undercut you.

The conventional advice on margin targets isn't wrong, but it's incomplete. A 30 percent margin calculated on a labour estimate that ignores your non-billable hours isn't really 30 percent; it's an illusion that evaporates the moment you total up your actual year-end numbers. Fix the billable-hour maths first. Everything else in this guide is secondary to that one correction.

If you take one thing from this guide, prioritise speed of accurate quoting over sophistication of pricing theory. A good-enough quote sent from site today beats a perfect quote emailed three days later, almost every time.

Quote faster and more accurately with TradeWise

TradeWise is built for electricians who'd rather quote from the van than from a desk. The core advantage over building quotes manually is speed without losing accuracy: synced material pricing means your figures reflect current supplier costs automatically, not whatever you remembered from your last order.

Tradewisehq

Mobile quoting lets you turn a site survey into a professional, itemised quote before you've even left the client's driveway, using the same structure covered in this guide: assessment summary, itemised materials and labour, change-order terms, and a clear acceptance mechanic. Every accepted quote flows straight into job scheduling and invoicing, so nothing gets re-typed and nothing gets lost between the survey and the invoice.

If quoting speed and margin protection are what's costing you jobs or eating your profit, start a free trial of TradeWise and try the estimate builder on your next site visit.

Frequently asked questions about electrical quoting

What is the standard formula for pricing electrical work?

Materials plus labour plus overhead plus profit. Price your materials with a markup, calculate labour using your true billable hourly rate, add your overhead cost per hour, then apply a target margin, typically 25 to 40 percent on installation work.

Should I quote hourly or flat-rate for electrical jobs?

Use flat-rate for repeatable, well-defined tasks like socket installs or consumer unit swaps, and hourly or time-and-materials, capped with a not-to-exceed clause, for jobs with genuine unknowns like fault-finding or older rewires.

How do I calculate my true hourly rate as an electrician?

Divide your total annual overhead by your realistic billable hours per year, not your total working hours. Most electricians only bill 60 to 70 percent of their working day once driving, quoting, and admin are accounted for.

What should be included in a professional electrical quote?

An assessment summary, detailed scope of work, itemised materials and labour costs, permit or certification notes, payment schedule, warranty terms, and a change-order clause covering scope changes.

What's the difference between a provisional and a fixed electrical quote?

A fixed quote is a firm, binding price for fully-scoped work. A provisional quote reflects your best judgement where some scope remains unverified, and should be labelled explicitly so the client understands the final figure may change.
